DWC Cannabis Setup Guide: The Honest Build, the Daily Routine, and the Hard Truths Most Tutorials Skip

DWC Cannabis Setup Guide: The Honest Build, the Daily Routine, and the Hard Truths Most Tutorials Skip

DWC Cannabis Setup Guide: The Honest Build, the Daily Routine, and the Hard Truths Most Tutorials Skip

A grower came in last summer with a DWC problem we see constantly. He'd built a textbook 5-gallon-bucket DWC kit straight from a popular YouTube tutorial, run a clean veg, and was deep in flower when everything started slipping. His plants were drinking so much water he was topping up daily, his reservoir was creeping to 76°F because his tent ran warm with the lights on, and his pH was swinging hard between adjustments because such a small water volume buffers nothing. He was working twice as hard as he should have, fighting the system he'd built. The honest fix wasn't more nutrients, more peroxide, or a different brand of bottles, it was a bigger reservoir and a chiller. Two problems, one root cause: he'd built the system the beginner tutorials told him to build, and that system is undersized and undercooled for serious cannabis. He thought he'd done DWC wrong. He'd done exactly what the internet told him, and the internet was wrong.

Deep Water Culture is the highest-yielding hydroponic method most home growers will run, when it works. It also has the fastest, most brutal failure modes in cultivation: a reservoir that climbs above 72°F and a pump that quits can kill a plant in 24 hours. The difference between DWC delivering its yield ceiling and DWC collapsing into the root rot we covered in our root rot guide comes down to a handful of things tutorials skip: the right reservoir size, real temperature control, a clear philosophy choice on day one, and a real operational routine. This is the modern, honest DWC setup guide, with the hard truths that the bucket-and-bubbler tutorials leave out. We stock the chillers, air pumps, meters, and reservoirs this method requires, and we'll point to them only where they're genuinely the answer.

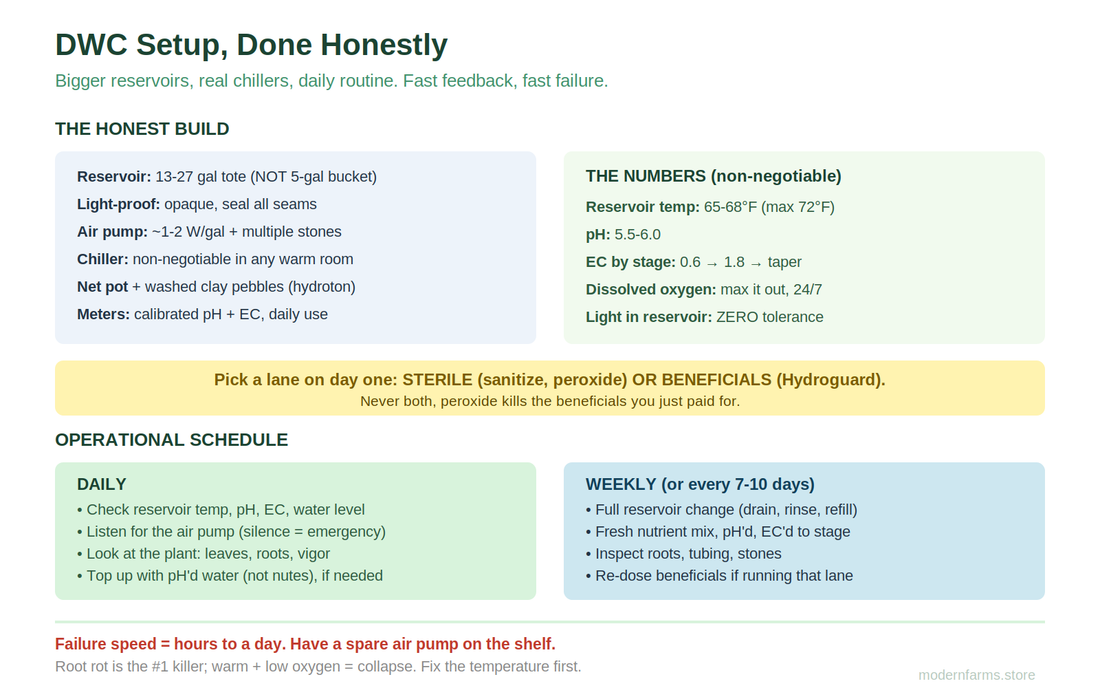

The 30-Second Answer

  • What DWC is: Deep Water Culture grows cannabis with roots hanging in a constantly oxygenated nutrient solution. No medium, just water + nutrients + dissolved oxygen, delivered on demand to the roots.
  • The non-negotiable numbers: reservoir 65-68°F (max 72°F), pH 5.5-6.0, EC ramped by stage, dissolved oxygen high (strong air pump + multiple air stones running 24/7), light-proof reservoir.
  • The build (honestly): bigger reservoirs than tutorials suggest (a 13-27 gallon tote per plant, not a 5-gallon bucket), a strong air pump with multiple stones, a water chiller in any warm room, calibrated pH and EC meters, and net pots with clay pebbles.
  • The philosophy choice on day one: sterile DWC (sanitized system, no microbes) or beneficial bacteria DWC (Hydroguard or similar inoculant). Pick one. Never run both at once.
  • Daily: check reservoir temp, pH, EC, water level. Weekly: full reservoir change. Mistakes hurt fast, your monitoring routine has to be daily, not "when I remember."

What DWC Is and Why It Works

In DWC, each plant sits in a net pot suspended over a sealed reservoir of oxygenated nutrient solution. The roots grow down through clay pebbles into the water below, where an air pump pushes oxygen through air stones to keep the dissolved oxygen high. Roots have constant, unrestricted access to three things at once: water, nutrients, and oxygen. They don't have to work for any of it.

That's the entire performance advantage. In soil, roots have to push through resistant medium and wait for nutrients to dissolve and migrate to them. In coco, the medium holds nutrients and water well but the plant still has to draw against it. In DWC, the roots are bathing in everything they need, so growth speed accelerates and the yield ceiling rises. Done right, DWC plants explode through veg and pack on flower weight faster than any soil-grown plant ever will.

The trade is brutal directness. With no buffering medium, every parameter (pH, EC, temperature, oxygen) is felt instantly by the roots. A pH crash in soil might give you three days to fix it; in DWC you have hours. This is the fundamental nature of the method: maximum reward in exchange for maximum responsiveness from the grower.

Should You Even Be Running DWC?

Before we walk you through the build, an honest check. As covered in our soil vs coco vs hydro guide, DWC is genuinely difficult for first-time growers because mistakes manifest in hours, not days. The yield ceiling is real, but it's reached by growers with the discipline to monitor daily and react fast.

Skip DWC for now and start with coco if any of these are true for you:

  • You can't check plants daily. DWC requires reservoir checks every single day, especially in flower. Twice-a-week growers will get burned.
  • You can't hold reservoir temperature. If your room runs above 75°F and you can't budget a water chiller (or your electrical setup can't support one), DWC will fight you the whole grow.
  • This is your first cannabis grow. DWC punishes the small environmental and feeding mistakes new growers make. Coco gets you 90% of the yield and growth speed without the failure-speed problem.
  • You're growing autoflowers exclusively. DWC works for autos but doesn't really help them, autos run on their own clock regardless. Coco is the better autoflower fit.

If those don't apply, you can monitor daily, you have temperature control or a chiller, and you've grown at least one clean cycle in something forgiving, DWC is a genuine yield upgrade and probably the next step. Read on.

The DWC Build (Honestly)

Here's the parts list, with sizing and reasoning the beginner tutorials skip:

Active Aqua Root Spa 5 Gal 8 Bucket System
Skip the parts hunting: a matched multi-bucket DWC kit, ready to plumb.
Shop
  • Reservoir: bigger than you think. The standard "use a 5-gallon bucket" advice creates two problems for serious cannabis: not enough water volume to buffer pH and nutrient swings, and not enough water to feed the plant during peak flower without daily topping up. Use a 13-gallon tote or larger per plant for a single-bucket build, or step up to 27-gallon totes for big plants. More water = more thermal stability + more nutrient buffering + less daily babysitting. The reservoir must be opaque or made light-proof (paint, foil wrap), light hitting the water grows algae and feeds pathogens.
  • Lid with net pot opening. A snug-fitting lid with a hole cut for the net pot. The lid seals out light and supports the plant. Foam or rubber gasket between net pot and lid blocks light leaks.
  • Net pot + clay pebbles (hydroton). The plant lives in a net pot filled with washed clay pebbles. Clay pebbles support the stem and hold moisture if your pump ever fails, buying you crucial hours. Rockwool cubes can sit in the pebbles to hold seedlings until roots descend.
  • Air pump. Sized to roughly 1 watt per gallon of reservoir as a starting point, more is better up to a point. A 13-gallon reservoir wants a ~15-20 watt pump minimum. Hang the pump (rubber-band it to a hook) to dampen vibration noise. Have a spare pump on the shelf. Pump failure is the single fastest way to kill DWC plants, roots die in hours without oxygen.
  • Air stones. Multiple stones beat one big stone. Two to four 4-6 inch stones in a 13-gallon reservoir produces vigorous, even bubbling that keeps dissolved oxygen high throughout the water column. Replace stones every few months as they clog.
  • Water chiller (this is the one you need). In any room that runs above ~75°F lights-on (which is most indoor tents), a water chiller is what holds the reservoir at 65-68°F reliably. Frozen water bottles and reservoir wraps are short-term stopgaps; a proper chiller is the only thing that holds temperature through a full grow without intervention. This is where DWC budgets fail, and it's where we'd push you hardest at the counter. No chiller in a warm room = root rot waiting to happen.
  • pH meter (calibrated) and EC/PPM meter. Non-negotiable. You cannot run DWC by feel. A Bluelab combo meter or pen-style meters get you started; see our Bluelab buyer's guide for the upgrade path.
  • pH up/down solutions. You'll be adjusting pH constantly. Hydroponic-grade up (potassium hydroxide) and down (phosphoric acid) solutions.
  • Hydroponic nutrients. Liquid nutrients formulated for hydroponics (General Hydroponics Flora, House & Garden, Athena, similar), no organic amendments that can clog air stones and feed pathogens.

Single-Bucket DWC vs RDWC vs Bubbleponics

Three variants worth understanding before you commit:

  • Single-bucket DWC (the standard). Each plant in its own isolated reservoir. Modular, easier to build, and critically, a problem in one bucket stays in that bucket. If a plant develops root rot or a pH crash, only that plant is affected. This is what most home growers should run.
  • Recirculating DWC (RDWC). Multiple buckets linked by pipes that share one large central reservoir, water circulates between them. Pros: consistency (every plant sees the same pH/EC/temp), easier maintenance at scale (you only adjust one reservoir), bigger total water volume = better buffering. Cons: shared water means shared problems, root rot or pathogens spread through the whole system fast, and a single pump failure or leak affects everything. Skip RDWC until you've run a few clean single-bucket cycles.
  • Top-fed DWC (Bubbleponics). A small water pump drips nutrient solution onto the medium at the top of the net pot, keeping seedlings wet while their roots stretch down to the main reservoir. Solves the #1 first-DWC failure (seedlings drying out before roots reach the water), at the cost of one more pump that can fail. A reasonable variant for beginners doing their first DWC.

Start with single-bucket DWC, ideally with the bubbleponics top-drip variant if you're starting from seed. Graduate to RDWC only after you've proven the routine.

Setting Up: Step by Step

  1. Wash everything. Rinse the reservoir, lid, net pots, air stones, and clay pebbles thoroughly. Clay pebbles especially come dusty and need washing until the runoff is clear. Sanitize if going sterile.
  2. Assemble. Install air stones at the bottom of the reservoir, run airlines out through small holes (sealed) in the lid, connect to the pump. Fit the net pot through the lid opening.
  3. Fill and pre-run. Add water to about an inch below the bottom of the net pot at first, you want roots to reach down for the water, not start submerged. Add nutrients to a seedling-strength EC (around 0.6-0.8) and adjust pH to 5.8. Turn on the air pump; let it run for an hour to dissolve oxygen and stabilize before planting.
  4. Plant. Place a rooted seedling (in a rockwool cube or coco plug) into the clay pebbles in the net pot, with the cube buried in the pebbles. Position so the roots can grow down and reach the water within a few days.
  5. First-week handholding. Until roots descend into the reservoir, the seedling needs surface moisture. Either use a top-drip pump (bubbleponics) or hand-mist the clay pebbles 1-2× daily until you see roots in the water below. After roots reach the reservoir, the plant is on autopilot for water.
  6. Daily monitoring starts immediately. Even on day one, check reservoir temp, pH, EC. Get the habit before the plant matters.

The Non-Negotiable Numbers

  • Reservoir temperature: 65-68°F target, 72°F absolute max. This is THE number. Above 72°F you've lost dissolved oxygen and entered the temperature zone where Pythium (root rot pathogen) multiplies fast. Cool water also holds more oxygen physically, so it does double duty. Use a chiller; check temp daily.
  • pH: 5.5-6.0. Slightly more acidic than soil because nutrient availability in water peaks here. Check daily and adjust if outside this range. pH naturally drifts up as plants drink (especially in veg); some growers let it cycle 5.5-6.2 to give different nutrients their availability windows, others hold tight at 5.8.
  • EC by stage. Seedlings: 0.6-0.8 EC. Early veg: 1.0-1.3. Mid/late veg: 1.4-1.8. Early/mid flower: 1.8-2.2. Late flower: taper down. These are starting points; some genetics want more, some less. Watch the plant.
  • Dissolved oxygen: maximize. Vigorous bubbling across the whole reservoir surface; multiple stones; pump sized at 1-2 watts per gallon. You cannot easily over-aerate.
  • Light: zero in the reservoir. Any light leak grows algae and feeds pathogens. Tape every seam.

The Philosophy Choice: Sterile vs Beneficials

This is the fork in the road, and you have to pick a lane on day one. Both work; running them at the same time doesn't.

Sterile DWC. You sanitize the reservoir, hold cold water (~65°F), maximize oxygen, and run zero biology in the water. The cold + clean + oxygenated environment is hostile to pathogens. Some growers add hydrogen peroxide periodically to keep it sterile. Pros: clean, predictable, no biology to manage. Cons: any breach in the protocol (warm water, light leak, contamination) and there's no protective microbiome to help, you go straight to root rot.

Beneficial bacteria DWC. You inoculate the reservoir with beneficial microbes (Hydroguard / Bacillus, Great White / mycorrhizae) that colonize the root zone and outcompete pathogens. This is biological pest management for the root zone. Pros: forgiving (the beneficials buffer mistakes); harder for pathogens to establish because the good guys are already there. Cons: you have to actually dose the beneficials regularly, and hydrogen peroxide will kill them, so you can never run peroxide on a beneficials system.

For most home growers, we recommend the beneficials approach, the forgiveness factor is huge and matches the "no time to babysit" reality of most home grows. Sterile is excellent for growers with the discipline to maintain it. What doesn't work is "I added Hydroguard but also dosed peroxide when I saw a brown root", that's the worst of both worlds, you killed your beneficials and only partially knocked back the pathogens. Pick one. See our root rot guide for more on the peroxide-vs-beneficials decision.

The Weekly Operational Schedule

Here's the actual rhythm of running a DWC grow, the part most tutorials gloss over.

Every day:

  • Check reservoir temperature (should be 65-68°F).
  • Check pH; adjust if outside 5.5-6.0.
  • Check EC/PPM; adjust if drifted significantly.
  • Check water level; top up with pH'd water (not nutrient solution, see below) if more than ~10% has been consumed.
  • Look at the plant: leaves, roots through a flashlight peek into the reservoir, general vigor.
  • Listen for the air pump. Silence is an emergency.

About top-ups: when plants drink water, nutrients concentrate (EC rises). When you add plain water to top up, you're diluting back toward the original strength. Top up with pH'd water until the volume is back to normal, then check EC and adjust if needed. Don't add full-strength nutrient solution to top up, you'll keep concentrating salts.

Every week (or every 7-10 days): full reservoir change. Drain the entire reservoir, rinse out any biofilm or sediment, refill with fresh, pH-adjusted, properly EC'd nutrient solution. Root exudates and accumulated salts make the old solution increasingly hostile over time. Weekly is the rhythm most growers settle on; bigger reservoirs can sometimes stretch to 10-14 days.

Monthly (or between grows): deep clean the air stones (soak in vinegar or hydrogen peroxide to dissolve mineral buildup), replace if clogged. Inspect tubing for algae and clean. Confirm chiller is running clean.

Common DWC Failures (and the Root Rot Handoff)

The classic ways DWC grows die, ranked by frequency:

  • Root rot. Hands down the #1 killer. Warm reservoir + insufficient oxygen + maybe a light leak = brown, slimy, foul-smelling roots and a collapsing plant. Cool water, strong aeration, and beneficial bacteria prevent it; our root rot guide is the companion to this setup guide and covers diagnosis, emergency triage, and the peroxide-vs-beneficials decision in depth.
  • Air pump failure. A failed pump silently kills roots in hours. Have a spare pump on the shelf at all times. Some growers use battery backup or two pumps in parallel for redundancy.
  • pH crash. pH swinging suddenly low (often to 4.0-4.5) damages roots and locks out nutrients. Usually caused by root rot starting, microbes acidifying the water. Daily pH checks catch this before it cascades.
  • EC drift and nutrient lockout. Salts build up over time even with topping up; if you never change the reservoir, EC climbs and nutrient ratios skew. Weekly reservoir changes prevent this entirely.
  • Light leaks. Often discovered too late when algae appears or root rot starts. Inspect for any pinpricks of light in the reservoir lid and seams.
  • Undersized reservoir. Plants drink faster than the reservoir can buffer in flower, leading to daily top-ups and pH/EC instability. The fix: bigger reservoirs from the start (see the build section above).

When to Upgrade or Graduate

If your first DWC runs go well, the natural progression is bigger reservoirs (27+ gallon totes), full RDWC for multi-plant builds, and eventually automated dosing systems and environmental controllers that read pH/EC/temp continuously and adjust without intervention. The ceiling of DWC at the high end is very high.

If your first DWC runs are rough, that's normal too, this is the medium with the steepest learning curve. The honest call: if you've had two runs collapse from root rot or pH crashes despite a chiller and a real routine, you may be better served by coco for a season to consolidate the fundamentals (VPD, feeding, training) without the failure-speed problem, then returning to DWC stronger. There's no shame in dropping back; it's how many successful DWC growers got there in the end.

What We'd Tell You at the Counter

Build bigger than the tutorials say. Skip the 5-gallon bucket; start at 13 gallons per plant or larger. More water buffers your mistakes, holds temperature better, and keeps you from topping up every day in flower. The cost difference is minor; the difficulty difference is huge.

Budget the chiller. In any indoor room above ~75°F lights-on (which is most rooms), a water chiller isn't optional, it's the part of the build that decides whether you produce a clean harvest or fight root rot for ten weeks. We'd rather see you spend $300 on a real chiller and run for years than skimp and lose a crop to a 78°F reservoir.

Pick a philosophy on day one and stay in your lane. Sterile or beneficials, never both. Running peroxide on a Hydroguard system is the worst-of-both-worlds mistake we see constantly. Pick the approach that fits your routine and commit.

And monitor daily, or don't run DWC. The fastest failure speed in growing demands the most consistent routine. If you can't honestly commit to a daily check of pH, EC, temp, and water level, you'll have a better grow in coco. Match the system to the routine you actually have. We don't upsell, we'd rather sell you a coco setup that produces a clean first harvest than a DWC kit that collapses on you.

DWC is one method; the broader Method & Medium context is in our soil vs coco vs hydro guide and the hydroponic methods overview, the failure-mode companion is our root rot guide, the environmental discipline that supports any hydro grow is in our VPD chart guide and ventilation guide, the meters that make DWC manageable are in our Bluelab buyer's guide, and the whole timeline lives in the week-by-week grow guide.

Frequently Asked Questions

What temperature should a DWC reservoir be?

Target 65-68°F (18-20°C), with 72°F as the absolute maximum. This range maximizes dissolved oxygen and is hostile to the Pythium pathogens that cause root rot. Above 72°F the reservoir holds less oxygen and pathogens multiply rapidly, making warm water the #1 cause of DWC failure. In any room running above ~75°F lights-on, a water chiller is the reliable way to hold reservoir temperature; frozen bottles and insulation wraps are short-term stopgaps only.

How often should I change the water in a DWC system?

Most growers do a full reservoir change every 7-10 days. Plant roots release exudates and salts accumulate over time, making the old solution progressively less hospitable. Top up with pH'd water (not full-strength nutrient solution) between full changes to maintain volume without concentrating salts. Larger reservoirs (13+ gallons) can sometimes stretch to 10-14 days; smaller setups need weekly changes.

Is DWC better than soil or coco for cannabis?

Yield ceiling: yes, when dialed in. Real-world for beginners: usually no. DWC's yield advantage requires daily monitoring, temperature control, and fast reactions to problems, the kind of discipline that takes practice. For first-time growers, a clean coco or soil grow typically beats a wobbly DWC grow because DWC's failure modes (root rot, pH crashes, pump failures) develop in hours and punish the small mistakes new growers make. DWC is the right choice when you have the routine; coco is usually a better starting point.

What pH and EC should DWC cannabis run at?

pH: 5.5-6.0, slightly more acidic than soil because nutrient availability in pure water peaks in this range. Some growers cycle 5.5-6.2 to hit different nutrients' optimal availability; others hold tight at 5.8. Adjust daily as needed. EC by stage: seedlings 0.6-0.8, early veg 1.0-1.3, mid/late veg 1.4-1.8, early/mid flower 1.8-2.2, late flower taper down. Genetics affect tolerance; watch the plant and adjust if you see deficiency or burn signs.

Can beginners run DWC successfully?

They can, but they often shouldn't on the first cannabis grow. DWC's fast failure modes (root rot in 1-2 days, pump failure in hours, pH crashes that cascade quickly) punish the small environmental and feeding mistakes new growers make. A first-time DWC grower with a chiller, a daily monitoring routine, and willingness to react fast can succeed. A first-time grower trying to learn cannabis fundamentals and DWC simultaneously usually struggles. The honest recommendation: run one or two clean coco cycles to learn VPD, feeding, and training, then move to DWC for the yield ceiling.

What size reservoir do I need for DWC cannabis?

Bigger than most tutorials suggest. Skip the 5-gallon bucket; start at a 13-gallon tote per plant or larger, and step up to 27-gallon totes for big plants in flower. More water means more buffering against pH and EC swings, more thermal stability (less temperature spiking), and less daily topping up during peak flower drinking. The marginal cost of a bigger reservoir is small; the difficulty reduction is large. The 5-gallon-bucket DWC standard was popularized for small grows and beginner tutorials; serious cannabis runs better in larger reservoirs.
